Equipment· Oct 2026·7 min read

Pond Aerators for Commercial Fish and Shrimp Farms: How to Choose

Also in:EspañolPortuguêsFrançaisالعربية中文Türkçe日本語한국어NOSV

Pond Aerators for Commercial Fish and Shrimp Farms: How to Choose
Free RAS feasibility calculatorCheck CAPEX, payback and return for your project before you request quotes.Open the calculator

Short answer: Choose commercial pond aerators by defining peak oxygen demand, matching oxygen transfer and circulation to pond geometry, and providing reliable backup power. Compare documented performance at equivalent test conditions, then calculate installed and operating costs. For RAS, hatcheries and cages, assess the oxygen-delivery method separately rather than transferring pond horsepower rules to a different production system.

Paddlewheel aerators running in a shrimp pond at sunrise
Paddlewheel aerators running in a shrimp pond at sunrise

How much aeration does a commercial pond need?

Project-specific requirement: Size for the most demanding credible operating condition, not average biomass. The oxygen budget must account for stock respiration, sediment and microbial demand, feeding, temperature, salinity and minimum acceptable dissolved oxygen. Nighttime conditions and the loss of an aerator also belong in the design assessment.

Verified historical context: Boyd’s 1998 pond aeration review reports aeration intensities from about 1–2 kW/ha in extensive fish culture to 15–20 kW/ha in intensive marine shrimp culture. It also discusses roughly 500 kg of additional production per kW of aeration. These are historical observations, not sizing rules or production guarantees for a new farm.

Planning estimate: Use the Aquaculture Aeration Calculator or Shrimp Pond Aeration Calculator to explore assumptions. For oxygen-supply budgeting, the Commercial Oxygen Demand & LOX Cost Calculator is a separate planning aid. Calculator outputs require engineering review; they do not establish safe stocking capacity.

Which aeration technology fits ponds, RAS, hatcheries or cages?

ApplicationEquipment to evaluateDecisive procurement checks
Shallow shrimp or fish pondsPaddlewheels and other surface aeratorsHorizontal circulation, operating depth, erosion risk, gearbox duty and materials
Deeper pondsAspirators, diffused air or combined systemsMixing depth, oxygen distribution, sediment disturbance and service access
Raceways and hatcheriesBlowers and diffusers; supplemental oxygen where requiredSpecies-specific turbulence limits, air distribution, cleanability and redundancy
Biofloc tanksBlowers, diffusers and supplementary mixingOxygen demand plus solids suspension, pressure losses and failure coverage
Intensive RASAeration plus engineered oxygen delivery where neededPeak demand, oxygen supply, pressure, controls and emergency response
Open-water cagesSite-specific supplemental oxygenation, if feasibleAmbient oxygen, currents, depth, deployment and containment feasibility

Project-specific selection: No technology is automatically best. Hatcheries may need separately controlled zones for different life stages; RAS oxygenation must fit the treatment loop; cage equipment cannot compensate reliably for an unsuitable site. Require a layout and operating narrative showing where oxygenated water travels and how dead zones are addressed.

When should buyers choose paddlewheel or aspirator aerators?

Paddlewheels are candidates where surface oxygen transfer and horizontal circulation are both needed. Require placement drawings showing flow direction, clearances, anchoring and interaction with drains or pond liners. Waste movement toward a collection area depends on the complete layout—it is not guaranteed by buying a paddlewheel.

Verified historical example: Global Seafood Alliance’s discussion of mechanical aeration efficiency describes Thai shrimp ponds using 24–36 hp/ha, approximately 18–27 kW/ha, for roughly 20 hours daily over 60–100-day crops. This illustrates demanding duty, not a recommended equipment schedule.

For paddlewheels, specify motor duty, gearbox lubrication, seals, bearings, paddle construction and corrosion protection. Aspirators combine propeller-driven flow with air entrainment, but bubble size and effective mixing depth depend on the design. Ask for evidence at the proposed shaft angle and immersion depth; do not accept a generic claim that an aspirator eliminates bottom-water oxygen deficits.

How should buyers specify blowers and diffusers?

Specify required airflow at operating pressure, not free-air capacity alone. Pressure must cover diffuser submergence, pipe losses, valves and diffuser resistance. Ask how performance changes as diffusers foul, how branches are balanced and whether individual zones can be isolated without stopping the whole farm.

Fine-bubble systems can provide useful oxygen transfer, but depth, water conditions and fouling affect actual results. Biofloc systems also need enough mixing to suspend solids; a system adequate for oxygen transfer may still need additional mixing. Request diffuser cleaning procedures, replacement access, blower noise and heat data, enclosure ventilation and standby arrangements.

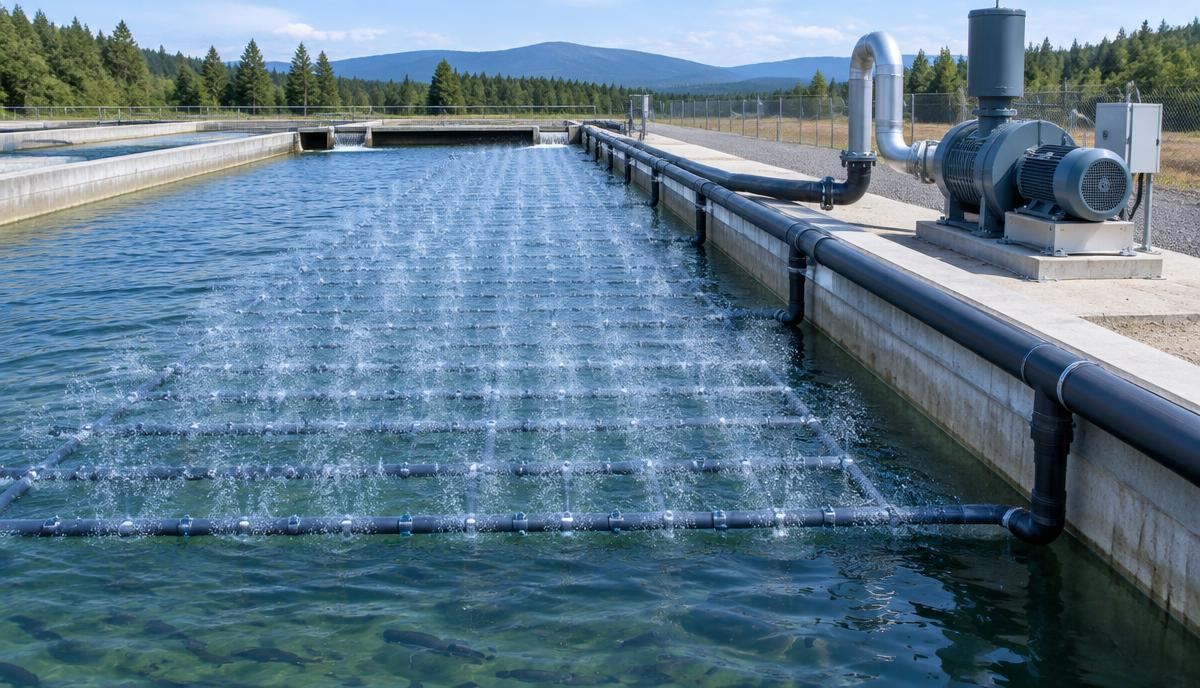

Fine-bubble aeration grid and blower at a commercial fish raceway
Fine-bubble aeration grid and blower at a commercial fish raceway

When does a RAS need oxygen cones instead of more aeration?

Oxygen cones dissolve supplied oxygen into a water stream; they are not air-driven pond aerators. Evaluate them when the project oxygen balance shows that atmospheric aeration cannot meet the required demand and dissolved-oxygen targets. Cones are one option, not an indispensable component of every intensive RAS.

Project-specific checks include water flow, operating pressure, oxygen feed, materials, pressure protection and control response. Compare the complete package: oxygen source, storage or generation, delivery equipment, instrumentation and emergency supply. Oxygen addition does not replace carbon dioxide removal or the rest of water-quality treatment.

What must an aeration specification and RFQ include?

Issue one design basis to every bidder. Identify measured inputs, planning assumptions and unresolved site data separately so suppliers cannot silently price different duties.

  • Production basis: species, life stage, peak biomass, maximum daily feed and seasonal operating schedule.
  • Water basis: temperature and salinity ranges, elevation, minimum dissolved-oxygen target and available monitoring records.
  • Geometry: pond or tank dimensions, operating depths, liners, drains, access and proposed equipment locations.
  • Duty: oxygen demand by zone, circulation or solids-suspension requirements, operating hours and contingency cases.
  • Utilities: voltage, phase, frequency, grid limitations, backup power and available oxygen supply.
  • Construction: component-specific material grades, corrosion protection, electrical enclosure requirements and anchoring.
  • Scope: equipment, cabling, panels, pipework, civil interfaces, installation, controls, training and commissioning responsibilities.
  • Acceptance: test conditions, measurement methods, required documents and remedies if agreed equipment performance is not achieved.

For broader procurement sequencing, use the aquaculture equipment sourcing guide. Keep missing water or load data visible rather than asking suppliers to conceal uncertainty inside a fixed equipment count.

How do you compare oxygen transfer and energy efficiency?

Request Standard Oxygen Transfer Rate (SOTR) and Standard Aeration Efficiency (SAE), with the test method, conditions and exact equipment configuration. SOTR expresses oxygen transfer under standardized conditions; SAE relates that transfer to power input. Ask whether reported power is measured electrical input or another basis.

Verified technical distinction: Boyd’s review explains standardized aeration performance and its relationship to field conditions. Standard test results are not a promise of equivalent transfer in warm, saline, oxygenated pond water. Require the designer to state field corrections and operating assumptions.

Prefer traceable independent test reports. If only manufacturer testing is available, record that evidence limitation and agree an appropriate verification process. Compare identical system boundaries, including blowers, pumps and auxiliary loads where applicable. Reject comparisons based only on motor horsepower or unexplained efficiency percentages.

What power backup and monitoring should be included?

Define which oxygen-delivery and monitoring functions must survive an outage. Generator assessment needs running loads, motor-starting requirements, start sequence, site conditions and other essential loads—not simply the sum of aerator nameplates. The Aquaculture Generator Sizing Calculator provides a planning estimate for specialist review.

Specify automatic transfer where required, alarms, protected control power, emergency procedures and realistic restoration time. Variable-frequency drives may help with starting or control, but require equipment compatibility checks. Test backup operation during commissioning, including communications failures and low-oxygen alarms. The dissolved oxygen management guide provides related operating context.

What should quotes include, and what drives landed cost?

Require an itemized bill of quantities, equipment models, performance documents, exclusions, shipping dimensions, delivery assumptions, quote validity and payment milestones. Include installation supervision, commissioning, training, warranty conditions, service arrangements and priced critical spares. Confirm who supplies connection hardware and who owns each interface.

Landed and installed costs may include packing, freight, insurance, duties, taxes, brokerage, port handling, inland transport, unloading, foundations, electrical work and commissioning travel. Verified contractual point: ICC Incoterms rules allocate specified delivery obligations, costs and risks. State the rule, named place and version; separately define payment, acceptance and warranty.

Planning assumption: Compare energy using measured or supported electrical input, expected operating hours and the applicable tariff, including relevant demand charges. Add servicing, cleaning, replacement parts and backup-system costs. The Global Seafood Alliance historical example estimated aeration electricity at USD 0.41–0.53/kg of shrimp; this is not a current budget benchmark. Do not assume higher purchase price automatically means lower lifetime cost.

What red flags should stop an aerator purchase?

  • A fixed horsepower-per-hectare recommendation without biomass, feed or water conditions.
  • Standard oxygen-transfer figures presented as guaranteed pond performance.
  • Unsupported production, survival or energy-saving promises.
  • “Corrosion-resistant” construction without component-specific materials.
  • A blower quote without airflow at duty pressure or a circulation proposal without a layout.
  • Undefined spare-parts lead times, installation exclusions or warranty remedies.
  • Backup equipment selected without a starting-load and transfer assessment.

What is the final commercial aeration buying checklist?

  • Confirm the peak oxygen budget and mark unresolved assumptions.
  • Review circulation, mixing and operating depth separately from oxygen transfer.
  • Normalize test evidence, power boundaries and quoted scope.
  • Check outage coverage, alarms and maintenance access.
  • Compare landed, installed and operating costs on one basis.
  • Agree commissioning tests, documentation, training and handover responsibilities before ordering.

How can FishMatch Group review your aeration RFQ?

For commercial projects generally USD 250,000 and up, submit your design basis, drawings and scope gaps through the human-reviewed project RFQ intake. FishMatch Group is independent and supplier-neutral; no supplier identities are shared with buyers. Its procurement service does not manufacture equipment, lend money or guarantee results. This guide supports planning, not project-specific engineering or financial advice.

Common questions

Frequently asked questions

Use horsepower per hectare only as preliminary context, not a final design basis. Required capacity depends on peak biomass, feed load, water conditions, sediment demand and circulation. Historical published rates are not guarantees for a new project.

SOTR measures oxygen transfer under standardized conditions, while SAE relates that transfer to power input. Request the test method, equipment configuration and power-measurement basis. Actual pond transfer requires project-specific corrections.

Specify required airflow at the operating pressure, including water depth, pipe losses and diffuser resistance. Also define zone balancing, fouling allowance, cleaning access and standby arrangements. Free-air capacity alone is insufficient.

No. An oxygen cone is one oxygen-delivery option to assess against the project's oxygen balance and treatment layout. Its selection also requires consideration of oxygen supply, water flow, pressure, controls and emergency coverage.

Check packing, freight, insurance, duties, taxes, brokerage, inland transport and unloading against the agreed delivery scope. Add installation, electrical work, commissioning and critical spares where excluded. State the Incoterms rule, named place and version, while defining warranty and acceptance separately.

Key figures

Figures quoted in this guide. Indicative planning numbers — supplier quotes confirm final values.
FigureValueContext
Size / capacity1–2 kW; 15–20 kWVerified historical context: Boyd’s 1998 pond aeration review reports aeration intensities from about 1–2 kW/ha in extensive fish culture to 15–20 kW/ha in intensive marine shrimp culture.
Size / capacity500 kgIt also discusses roughly 500 kg of additional production per kW of aeration.
Size / capacity18–27 kWVerified historical example: Global Seafood Alliance’s discussion of mechanical aeration efficiency describes Thai shrimp ponds using 24–36 hp/ha, approximately 18–27 kW/ha, for roughly 20 hours…
CostUSD 0.The Global Seafood Alliance historical example estimated aeration electricity at USD 0.
CostUSD 250,000For commercial projects generally USD 250,000 and up, submit your design basis, drawings and scope gaps through the human-reviewed project RFQ intake.
